Spoke to Suresh from the Loan Studio and got verbal approval of ability to apply for a home loan as well as received a loan break down for repayments and contributions.
Was then introduced to Vera who would be our consultant for the remainder of the process.
FEB 2015:
Visited Warralily Display and signed quote with Brian from Carlisle Homes for the Addison 24 Mk2.
FEB 2015:
Chose land from Warralily Promenade "Lot 3125, Stage 31, Ackland St, originally to title August 2015.
MAR 2015:
Paid $1000 deposit to Warralily developer to hold land, paid $1000 deposit to Carlisle Homes for house. Introduced to Nicki our CLE on the phone
MAR 2015:
Paid balance of land deposit (5%) to Warralily and signed Contract of Sale for land. Sent Contract of Sale to Conveyancer to review, who would then send to Loan Studio to show the bank.
MAR 2015:
Colour browse at Carlisle Homes Spectra Showroom with 'Sally'
JUNE 2015:
Colour Selection Appointment
JUNE 2015:
Tender Appointment and payment of remainder of 5% to Carlisle Homes
JUNE 2015:
Told of delay in land titling/settling and new estimate is Sept/Oct
JULY 2015:
Contract Signing Appointment
JULY 2015:
Applied for First Home Owners Grant
JULY 2015:
Conditional approval from the bank and valuation from the bank for the land/construction comes back in.
JULY 2015:
Official approval from the bank for Land/Construction home loan.
AUG 2015:
Post contract variation for Kitchen Pendant lights over island bench
AUG 2015:
Land Title/Settlement Dates are delayed - New estimate Oct/Nov
NOV 2015:
Compliance received on the 1st
NOV 2015:
Land Titled 30th
DEC 2015:
Land Settles 13th
DEC 2015:
Trades on leave 20th December
JAN 19th 2015:
Developers Approval
Received updated floorplans from CH
"Waiting to receive property information back from council, once received CH can obtain engineering and building permit"
FEB 8th 2015:
Community Infrastructure Levy fee Paid – approx. $900 required as part of your developer requirements.
Asset Protection Permit – Footpath permit fee of approx. $130
Both paid at council in Geelong.
MARCH 1st:

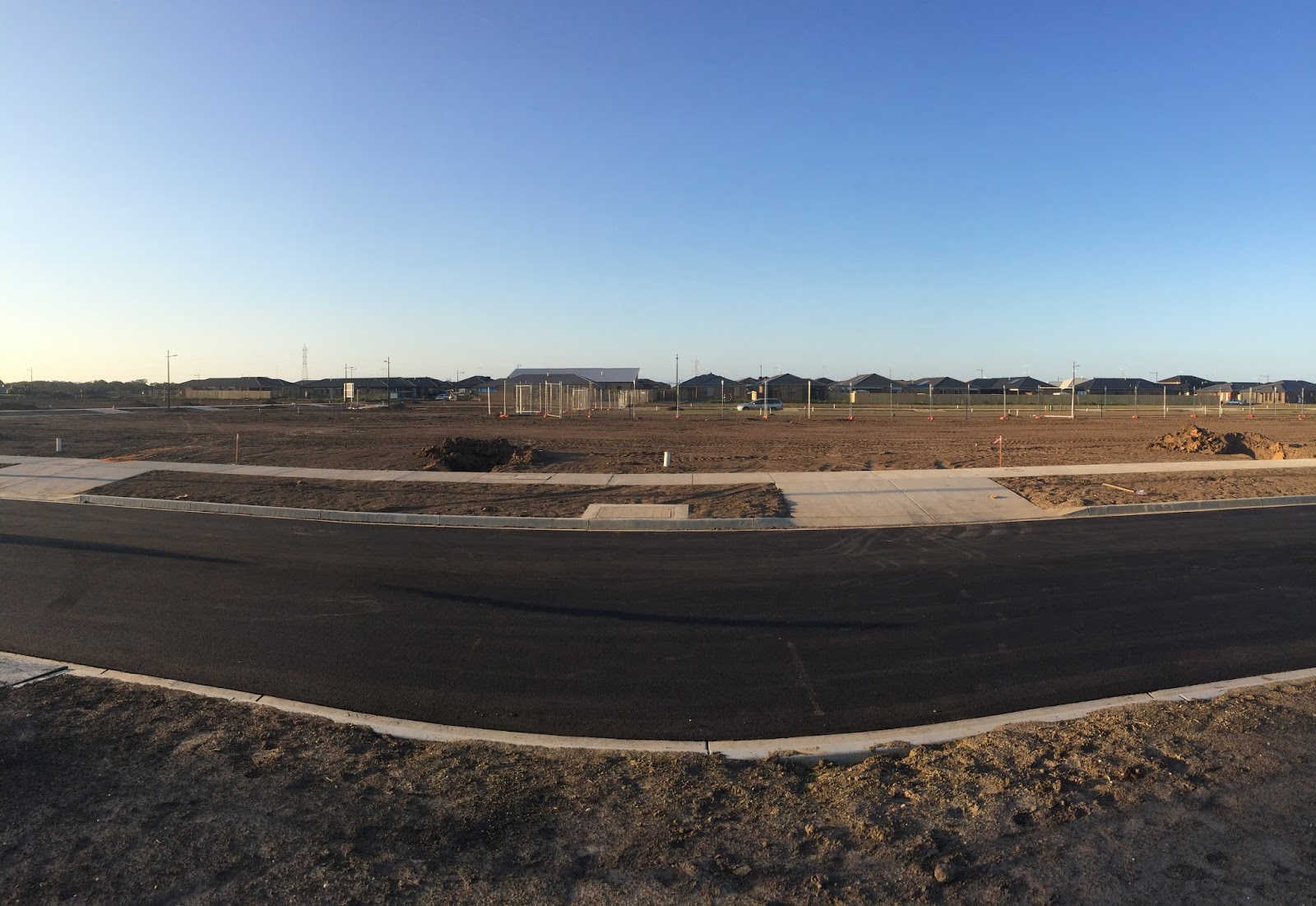

Site Start - Site Cut
MARCH 9th:
Drains
MARCH 15th:
Slab Finished
MARCH 23rd:
Frame Stage Complete
APRIL 1st:
Lock Up Stage Starts
Roof Cover Complete
External walls wrapped
Electrical Rough In
APRIL 16th:
Bricking 3/4 Finished (Awaiting master window from A&L)
Plaster Finished (Cornices and Architraves still to be installed)
Cabinetry Installed in Kitchen/Bathrooms/Laundry
Bricking Finished on Master and whole house
Internal Doors Delivered
Last Window delivered for master

Kitchen Cabinetry Completed (Stone still to come)
Master window Installed
Front Door Installed (Still to be stained)
Internal Doors Installed
Officially Locked Out of House
APRIL 30th:
Base renderArchitraves
Brick Clean
Waterproofing
MAY 8th:
Painting 3/4 Finished
MAY 15th:
Painting Complete
Tiling Started
MAY 22nd:
Stone benchtops installed
Tiling 95% Complete
MAY 27th-30th:
Plumbing completeElectrical Complete
Data Complete
Heating/Cooling Complete
Shower Screens
JUNE 1st:
Timber floors complete
Timer cladding complete
Garage door installed
Pendant Lights Installed
WIR Paintry Fitout
Caulking
No comments:
Post a Comment
